Commercial Generator Installation: A Guide for Large Facilities

Not all buildings experience blackouts the same way. An interruption takes away a mealtime from a restaurant. An outage costs a 400,000-square-foot warehouse much more. Refrigeration starts to lose its chill within minutes of the power going out. Operations come to a standstill. Medical monitors drain batteries not meant for extended power outages.

The U.S. Energy Information Administration reports that warehouses and office buildings consume more energy than any other type of facility in the country. Their need for electricity does not stop when the grid stops.

This guide discusses what commercial generator installation for large facilities involves and what facility management needs to know about the process before making decisions on this investment.

The Difference Between Large Buildings and Residential Installations

Residential electrical installations have a single point of entry into the building and a single main breaker panel with simple electrical loads. Commercial buildings such as an office complex spanning 250,000 square feet can have multiple points of utility entry, numerous panel boards, multiple voltage levels with three-phase distribution, and different load types.

Some machinery needs immediate reconnection after ten seconds or it turns off in ways that damage the operation. Other devices can wait. Some industrial machines require sequential power connection to prevent current surges that could trip the generator’s circuit breakers at the most inconvenient time.

Installing a generator to provide uninterrupted power for an industrial complex is not a backup power supply project in the traditional sense. It requires building another electrical infrastructure that operates in tandem with the primary source until it is restored.

FSG Inline Blog CTA
Related Reading A Guide for Handling Electrical Work in Industrial Facilities Learn about how industrial electrical work differs from other commercial applications.

Determining the Correct Size of the Generator

The first thing that comes to mind when deciding on generator size is the total connected load. Finding it is relatively simple. However, this approach often leads to an oversized unit.

The difference between the total connected load and the emergency load is that the latter represents the actual power consumption by critical components of a facility while the former includes anything that can potentially turn on at the same time. Most large buildings do not require their entire electrical infrastructure to remain operational in the event of a blackout. The discrepancy is often dramatic.

For example, a hospital with 200 beds needs 5,000kVA to sustain all operations in case of an outage. Sizing a generator by this parameter will cost upwards of $2 million. However, it may be sufficient to maintain life support and clinical services that account for 1,600kVA.

Industrial facilities face unique challenges associated with powering motors. A building spanning 300,000 square feet can use 2,000kVA to function normally. Yet, its operations may require an additional 600kVA during peak motor starting loads. A generator sized only based on running capacity will trip under this condition. Experienced engineers determine the optimal generator size using demand analysis techniques.

Load calculation comparison: connected load vs emergency load Connected load vs. actual emergency requirement Hospital (200 beds) Total connected 5,000 kVA demand analysis Emergency requirement 1,600 kVA Potential savings ~$560,000 Life safety: 300 kVA Critical clinical: 900 kVA Support systems: 400 kVA Manufacturing plant Total connected 3,500 kVA demand analysis Emergency requirement 2,000 kVA +600 inrush Potential savings ~$420,000 Process controls: 800 kVA Environmental systems: 700 kVA IT and material handling: 500 kVA Savings represent difference in equipment cost at $400/kVA. Actual costs vary by project.

Generac put together a generator sizing analysis for commercial and industrial applications detailing how loads, demand, and VFD’s affect the system specifications.

The Installation Process

There are three distinct stages in the installation process of generators for large commercial operations. Each stage creates the environment for the next.

Stage One: Design and Engineering (6 to 12 weeks)

In this stage, qualified installations distinguish themselves from costly disasters. Qualified designers build demand profiles based on facility operation data, not nameplate capacity. They consider growth expectations, motor startup transient loads, and harmonics generated by variable frequency drives. For systems with more than 750kW of power generation requirements, the majority of engineers prefer parallel generator designs to a single generator design because this provides redundancy and greater efficiency.

Stage Two: Site Preparation (8 to 16 weeks)

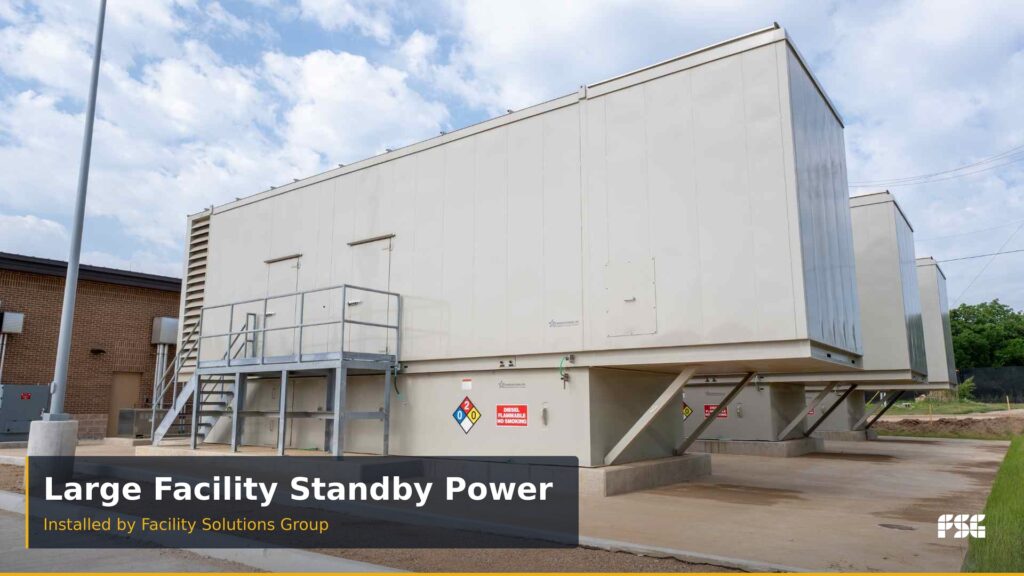

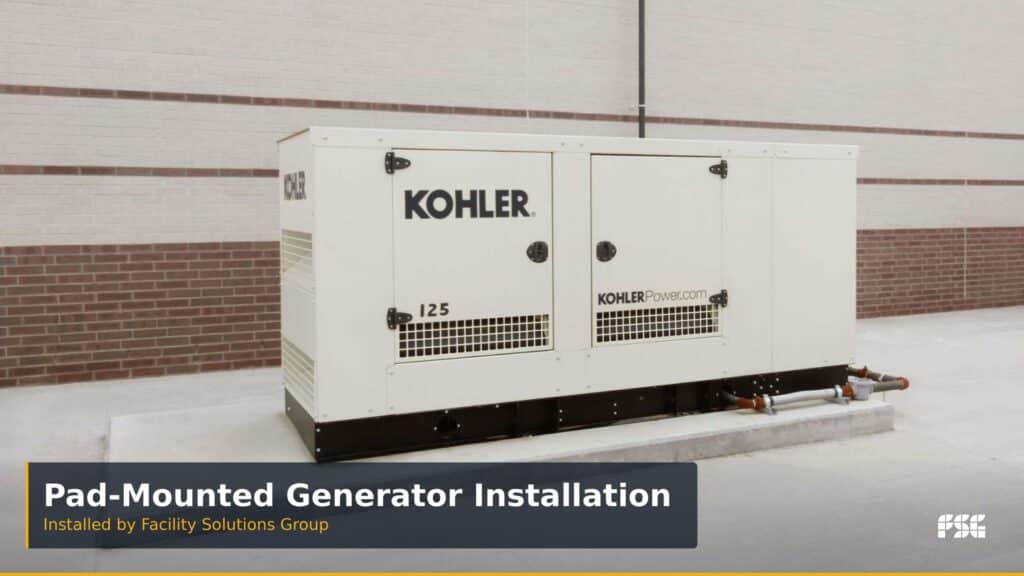

Generator pads need to bear static loads of more than 22,000 pounds and resist vibrations. Fuel storage is frequently underestimated. A 1,500kW generator burns close to 95 gallons of fuel per hour, meaning 48 hours of runtime requires over 4,500 gallons. All infrastructure including electrical rough-in, exhaust piping, and integration with the building management system is completed in this stage.

Stage Three: Installation and Testing (6 to 10 weeks)

Equipment is installed, electrical connections are made, and the testing sequence begins. The quality of the commissioning process determines how well the system functions when it is actually needed.

Commercial generator installation timeline Typical Project Timeline 1 Phase 1 — Engineering and design 6 to 12 weeks | Generator configuration, transfer switch strategy, fuel storage approach Design complete 2 Phase 2 — Site preparation and infrastructure 8 to 16 weeks | Pad, fuel system, exhaust, electrical rough-in, BMS integration Site ready 3 Phase 3 — Installation and commissioning 6 to 10 weeks | Equipment setting, electrical tie-in, load bank testing, witnessed testing System live Total project duration: 5 to 9 months Key decisions at each phase Phase 1: Generator count and configuration, transfer switch strategy, fuel storage approach Phase 2: Pad location, above vs. below-ground tank, exhaust routing, electrical rough-in Phase 3: Outage window coordination, load bank testing scope, BMS integration, witnessed testing

Load Bank Testing: What Gets Skipped on Most Projects

When it comes to cutting corners, there is no bigger area than commissioning, and there is no place where the repercussions are more obvious.

Load bank testing is done in incremental steps corresponding to actual load requirements: 25%, 50%, 75%, and 100% of rated capacity, followed by a brief 110% overload test. It reveals weaknesses in cooling, alternator output, or fuel delivery under prolonged high loads. It is far better to find these faults during commissioning, with time to address them, than during the first actual blackout.

Code and Compliance Basics

NFPA 110 sets all requirements regarding performance of emergency and standby power systems. Level 1 covers life-safety applications such as hospitals and fire suppression systems, requiring transfer in 10 seconds or less and a fuel supply capable of sustaining operations for at least 24 hours. Level 2 covers typical commercial and industrial applications where transfer in up to 60 seconds is considered adequate.

NEC compliance for standby power involves Articles 700, 701, and 702. Typically, commercial generators are classified as optional standby under Article 702. However, when fire pumps are required, portions of the installation must comply with the stricter requirements of Article 700 and Article 701.

Commercial generator installations must also satisfy EPA emissions requirements for stationary engines, which govern exhaust standards, permissible runtime during testing, and fuel specifications.

Required transfer speed by facility and load type Five tiers showing how quickly backup power must be restored for different facility types. Required transfer speed by load type 10 sec Healthcare life safety Emergency egress, fire pumps, surgical suites (NFPA 99) 10 sec Data centers Must stay within UPS battery runtime window 15 sec Manufacturing process controls PLCs drop state beyond this threshold 30 sec Cold storage and refrigeration Tolerable without product temperature impact 30 to 60 sec General commercial Office and retail general loads 0 sec 15 sec 30 sec 45 sec 60 sec

What a Commercial Generator Installation Actually Costs

Industry sources commonly cite $300 to $450 per kilowatt as a rule of thumb for commercial generator costs. That figure reflects equipment only. It leaves out installation labor, engineering, fuel systems, permitting, and contingency, which together can match or exceed the equipment cost on a large project.

For a 1,500kW system under typical site conditions, the all-in number lands around $1,012,000, or roughly $675 per kilowatt. The chart below shows exactly where that budget goes across equipment, installation, and soft costs.

1500kW commercial generator installation cost breakdown 1,500kW Generator Installation — Cost Breakdown Equipment $545,000 54% of total Installation $305,000 30% of total Soft Costs $162,000 16% of total Equipment Installation labor Soft costs $0k $50k $100k $150k $200k $250k $300k $350k Generator unit Paralleling switchgear Transfer switches Fuel tank Load bank Electrical work Pad and equipment Fuel system Exhaust system Commissioning Contingency Engineering and design Project management Permitting Total project cost (1,500kW system) Effective rate: ~$675/kW — nearly double typical industry estimates ~$1,012,000 Costs based on typical site conditions. Variables may increase totals by 15–40%.

Site conditions push that baseline higher. Difficult access adds 15 to 25%. Seismic requirements add 8 to 12%. Sound attenuation adds 12 to 18%. Electrical infrastructure upgrades can add another 20 to 40%.

ROI Calculations

For any operation where downtime has financial consequences, the case for a commercial generator installation is straightforward. A facility producing $85,000 per hour, with 1.5 outages per year averaging six hours each, faces $765,000 in annual exposure. A $1,000,000 installation reaches payback in under 18 months.

Similar calculations apply for cold storage, pharmaceutical manufacturing, data centers, and healthcare facilities.

According to research by Oak Ridge National Laboratory, a power outage on average costs business and industry clients $6,031 in 2024, and with a 29% increase in the number of power outages in the country since 2018, the risk for businesses has grown even more.

The question is not whether the capital investment is justified. It is whether the operation can absorb the cost of downtime. If the business cannot generate income during power failure, the decision is easy.

Finding the Right Partner

Engineering capability is the first thing to evaluate. A qualified contractor performs load analysis, short-circuit studies, and selective coordination analysis. They deliver a full engineered design, not a rules-of-thumb estimate.

A contractor who quotes a large facility project without asking detailed questions about operations and load profiles is working from assumptions. Learn more about FSG’s commercial generator installation services.

Factory-authorized dealers should be prioritized over independent distributors. Certified dealers receive technical training, engineering support, priority parts access, and manufacturer warranty backing.

Ask specifically what commissioning includes. Load bank testing should be a standard component of any professional scope. FSG’s commercial electrical services team can walk you through what a proper commissioning process looks like for your facility type.

Closing Thoughts

A well-planned commercial generator installation prevents losses that can easily surpass its cost in a single event. A poorly designed system that fails when it is needed makes the situation worse, compounding the very problem it was installed to solve.

FSG begins every project by understanding how a facility operates beyond its electrical drawings. We have engineered systems from 500kW to 4MW and above across manufacturing, healthcare, logistics, and data center environments where backup power is not optional.

Interested in a consultation on your facility’s needs? Contact FSG to schedule an assessment.

Commercial Generator Installation

Ready to protect your facility’s uptime?

FSG designs, installs, and maintains commercial generator systems built for large facilities — from initial load analysis to long-term service.

Explore Commercial Generator Services

Related Articles
