A Complete Guide to Commercial Solar: From Planning to ROI
Share Article
Switching to commercial solar doesn’t need to be about ideology. It’s a calculated operational decision to reduce operational costs and provide energy independence.
Commercial solar installation helps facility teams and business leaders balance budgets and meet sustainability goals. Solar systems can reduce energy bills, mitigate exposure to rising electricity prices, and create a measurable asset on the balance sheet.
Let’s start by answering the question: What is commercial solar?
What is Commercial Solar?
Commercial solar refers to photovoltaic systems designed and installed for commercial facilities and businesses. Businesses can utilize rooftop arrays, ground-mounted arrays, and even carport arrays to capture optimal sunlight,
The components of a commercial solar system include the solar panels, inverters and wiring, mounting hardware, and the interconnection to the utility.
The commercial solar market has been growing steadily as businesses seek to control costs and improve sustainability. The solar industry reports continued growth in commercial capacity year over year, driven by both corporate commitments and demand from utility-scale projects.
According to the Solar Energy Industries Association, “In 2024, the US solar industry installed nearly 50 gigawatts direct current (GWdc) of capacity, a 21% increase from 2023. This was the second consecutive year of record-breaking capacity.”
How Commercial Solar Actually Works

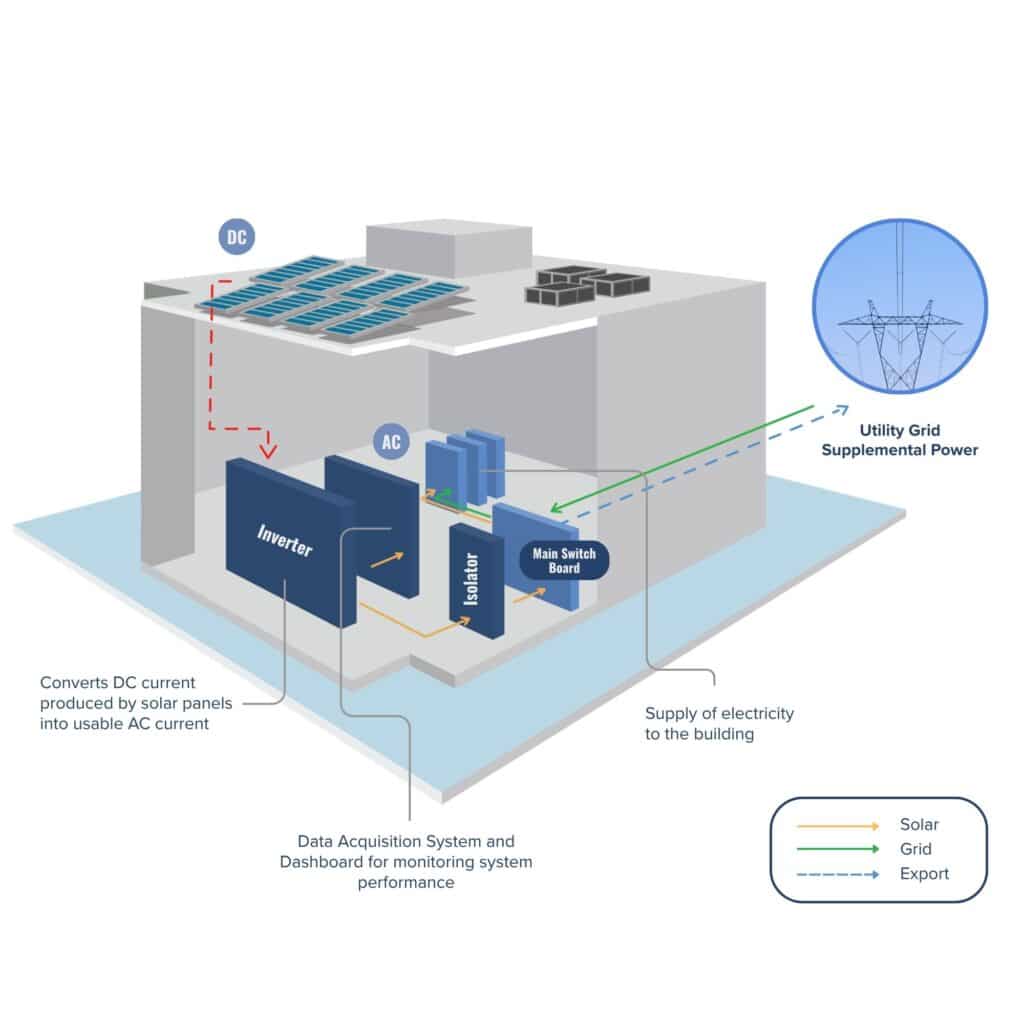

Solar systems convert sunlight into usable electricity through a multi-step process.
- Solar panels absorb sunlight through silicon semiconductors and generate electricity as direct current (DC). This process is known as the photovoltaic effect.
- The electricity is sent to an inverter, which transforms the electricity from DC to AC (Alternating Current). This allows the electricity to be used with more versatility in the building.
- The inverter feeds the electricity into the building’s electrical panel, or panels, where it gets distributed where it’s needed.
- The power generated is metered. If the sunlight produces more power than the building uses, the excess can be exported back to the electrical grid, stored in batteries, or curtailed, depending on the system design and local utility rules.
- Solar systems can be monitored and controlled to align with the building’s energy management strategy. For example, the site can shift loads, take advantage of demand response programs, or prioritize onsite consumption to maximize savings.
Commercial Solar Benefits for Business Owners
Solar delivers several practical benefits that make it a good choice for business owners, and there are three key reasons why owners, CFOs, and sustainability leaders look to solar as a way to meet their goals.
- Commercial solar reduces operational expenses by lowering the volume of energy purchased from the grid. For businesses looking for greater control over their electrical expenses, solar power offers a level of independence from energy rate fluctuations.
- Having a commercial solar system adds a durable asset to the property that can increase building value and marketability to tenants.
- Solar systems provide measurable sustainability data for reporting and compliance. Businesses with ESG or sustainability initiatives, as well as those looking to reduce their energy costs can get data that proves the value of the system.
Planning and feasibility: What to Evaluate Before Starting a Solar Project
Every solar project starts with a site assessment and a clear energy baseline. A solar contractor must evaluate the site to ensure they design the right system for your property.
A site assessment will look at several things:
- Available surface area and structural capacity for solar arrays
- Orientation, tilt, and shading that could affect direct sunlight
- Historical energy consumption data and peak demand
- Electrical panel capacity
- Interconnection rules and available utility rates
The site assessment utilizes this data to design a system that maximizes energy production and return on investment (ROI).
The design should provide an estimate of annual generation in kilowatt-hours, project savings based on your energy production and available incentives, and model payback and internal rate of return.
A reliable commercial solar contractor should have an understanding of local incentives, rebates, and program details. If you want to research solar incentives on your own, you can consult regional databases and incentive trackers, as state and utility offerings vary widely.
In July of 2025, the U.S. Government passed An Act to provide for reconciliation pursuant to title II of H. Con. Res. 14, also known as The Big Beautiful Bill. This act set deadlines for select commercial solar project rebates and incentives. You can learn more about the impact the bill will have on commercial solar on our podcast.
Designing a Commercial Solar System
Designing a solar system involves matching production to the customer’s objectives, and array location is a key design variable.
Location
Rooftop installation has different constraints than a ground array or a carport. Roof area, orientation, tilt, structural capacity, age, and obstructions all limit the number of modules you can place and at what angle they can be positioned.
Ground-mounted systems can use trackers and optimal tilt angles to their advantage. This raises energy production, but increases cost and maintenance. Ensuring enough space is available is another potential issue with ground-mounted systems.
Carports offer an additional location for solar panels. They can maximize surface area and often allow better tilt and airflow. However, they may require additional construction and reinforcement (such as column placement and parking lot spaces) that can conflict with the site.
Proximity to the electrical panel matters. Long DC or AC cable runs increase losses and increase costs for conduit and trenching. They also influence inverter sizing and whether to use centralized or distributed inverters.
Obstructions & Weather Considerations
Shade caused by trees, buildings, or mechanical equipment can cut electricity production. Anything that could obstruct sunlight from reaching the solar array needs to be considered. During the site assessment, the solar contractor will identify any obstacles that could prevent sunlight from fully reaching the solar panels.
Weather conditions, such as wind and snow, can also affect mounting choices and system structure. These conditions can affect expected output and maintenance intervals. Solar system designers will model temperature coefficients and cleaning schedules into the production and financial forecasts.
A comprehensive site survey and detailed production modeling ensure the solar array is sized properly and meets both energy goals and long-term operating realities.
“Behind the Meter” Vs. “In Front of the Meter”
In relation to commercial solar, you may often come across such terms as “behind the meter” and “in front of the meter”. Each of them describes different ways solar installations can be connected to the electricity grid and their functions in relation to power consumption.
With behind-the-meter solar installation, the solar panels are placed on the client’s premises, either on the roof or in a ground-based mounting system. The energy produced is consumed directly at the place where the panels are installed, reducing electricity consumption at the particular facility and thus saving money on utility bills. However, the surplus of electricity can be sent back into the grid in accordance with the applicable local regulations.
Front-of-the-meter solar installation includes large-scale utility solar power plants or energy storage facilities. They are connected to the electricity grid for the purpose of selling electricity directly to the grid, not to individual users. Electricity is transmitted through the meter and, hence, the projects are typically developed based on long-term PPA agreements.
FSG only provides services related to behind-the-meter solar projects for our clients in the industrial and commercial sectors. We design and install solar energy systems for commercial or industrial facilities, which allow reducing the costs of using electricity by such organizations.
Front-of-the-meter solar projects aimed at generating revenue from the sale of electricity to the grid are beyond our scope of practice. When it comes to solar projects, we focus on buildings of about 50,000 sq. ft. or more with suitable electricity usage.
The Cost of a Solar Project
Commercial solar is a costly investment for any business, but there are multiple ways to finance a solar system.
Loans, operating leases, and power purchase agreements (PPAs) are three financing options that are available to help finance a solar project. Each option has its own pros and cons, accounting treatment, and tax benefits claimer.
Download our Flyer to Learn more about Solar Financing Options
In addition to financing options, government and utility incentives and tax credits are reliable drivers of solar projects funding. However, they cannot be relied upon solely.
Proposed legislation can change incentives and program timeline eligibility and credit values at any time. For current federal and state-level incentives, rely on up-to-date industry trackers like DSIRE.
The chosen financing option, incentives, and the solar system itself will impact the payback period for a commercial solar installation project.
Typical commercial payback periods range widely. Factors that shorten the payback period include high local electricity rates, large daytime loads consumed on-site, favorable incentives, and system depreciation.
Many commercial projects reach payback within a handful of years to just over a decade, depending on those variables. Recent summaries show typical payback ranges of around five to fifteen years for most commercial settings.
Permitting is Often the Longest Part of the Process
Permitting, utility approval, and interconnection are often the longest part of the project process. They should start before the first piece of equipment is ordered.
A good solar project permit strategy should list every required approval, including building and structural permits, electrical permits, fire department sign-offs (if batteries are involved), and any environmental or storm water clearances for ground-mounted work.
For rooftop systems, many jurisdictions require a structural engineer’s letter, and some utilities expect full electrical one-line diagrams before they accept an interconnection application.
Utility interconnection is a critical yet lengthy part of the process, often taking weeks or months to obtain approval. The utility may require studies, protective relays, meter upgrades, or limits on electrical export depending on your system scope.
Early engagement with the utility company and submitting complete, accurate application packages shortens review times. Missing documents or design revisions are common causes of delay, so keeping track of any reviews and addressing outstanding items promptly is crucial.
Permitting timelines vary with local workload and project complexity. Smaller rooftop projects in cooperative jurisdictions can move quickly. Complex sites, historic districts, or large ground arrays near sensitive areas often need additional approvals and public notices.
It’s essential to factor in the length of time permitting and approval might take into your project schedule.
Construction
Once permits and interconnection approvals are in hand, attention shifts to site logistics, construction, and quality control.
Having a clear site plan for construction is essential. It must show where cranes and deliveries will stage, where material laydown will occur, and how crews will access the roof or array field without disrupting building operations.
Coordination with building managers and tenants early is important to plan elevator access, roof shutdown windows, and traffic control for large trucks.
Roof work demands specific protections for the building. Proper flashing, membrane penetration details, and attachment methods must meet both structural engineering requirements and the roof manufacturer’s warranty conditions.
If the roof needs reinforcement or replacement, it should be treated as a separate project phase. For ground and carport systems, coordinate foundation work, trenching for electrical runs, and stormwater management. Ensure proper safety and fall protection plans are in place and enforced.
Quality control during construction prevents O&M issues later. Standard practices should include torque checks for module fasteners, documented grounding continuity tests, and string-level I-V checks on inverters.
Be sure to keep a set of as-built drawings and photo documentation, as these are important for referencing during commissioning and future maintenance.
Commissioning the System
Commissioning the system is a sequence of inspections, measurements, and validation steps that prove the system meets contractual performance and safety requirements.
It starts with mechanical and electrical inspections that confirm that modules are installed to the specified orientation and tilt, that structural attachments are secure, and that conduits and terminations meet code.
Electrical testing is done at the string and inverter level. These tests include insulation resistance, polarity checks, and functional verification of safety switches and rapid shutdown systems.
Next is the performance testing. This is where measured production is compared to modeled expectations, accounting for weather and soiling. This establishes baseline performance metrics for the system, such as daily energy yield and system availability.
The monitoring platform should be tested with appropriate alerts and reporting for stakeholders. A commissioning report should include test results, as-built documentation, manufacturer warranties, and an O&M manual.
The commissioning process reduces risk and provides the data needed for warranty claims and for future performance tuning. Before final handover, the solar contractor should train the site operations team on basic monitoring, alarm response, and who to call for escalations.
Operation & Maintenance for a Commercial Solar System
A commercial solar system will continue to provide long-term value with consistent monitoring and proactive maintenance. A monitoring platform should provide near real-time production data and performance alerts, enabling facility teams to identify and address any issues promptly.
Detecting issues like shading, soiling, or equipment degradation early will keep the system performing optimally. Integration with building management systems can also reveal load trends and new opportunities for increased efficiency.
Routine maintenance should consider the site’s environment and workload. In dusty or industrial areas, more frequent cleaning may be necessary to maintain proper output. Regular inverter inspections, firmware updates, and electrical testing keep the system safe and efficient.
A good solar contractor will likely offer an O&M or a service & maintenance plan for your system. See FSG’s solar service and maintenance plan.
A clear O&M plan will define response times, outline who is responsible for repairs, and ensure spare parts are available when needed. Documenting inspections and production data supports warranty claims and helps identify long-term trends.
Servicing and maintaining a solar system can be tricky, and it’s recommended that it be handled by a professional solar contractor. Budgeting for a maintenance plan from the start allows businesses to protect both system performance and projected payback over the life of the array.
How to Integrate Solar With Other Building Systems
Commercial solar is most valuable when it is part of a broader load management and energy efficiency strategy. Integrating the solar system with building management systems can also reveal load trends and identify new opportunities for efficiency.
For example, pairing solar with battery storage enables facilities to store excess power generation. This allows facilities to use it when grid prices spike, reducing demand charges and providing backup power during outages.
When solar is integrated into a building management system, facilities can take energy efficiency optimization even further. Building systems such as HVAC, lighting, and process loads can be scheduled or adjusted to align with solar production. This minimizes peak demand and maximizes on-site energy use.
This level of coordination can also uncover opportunities to shift loads or automate controls for greater efficiency, but requires planning during design so communications, controls, and metering are aligned.
A well-planned integration not only lowers operating costs but also positions the facility for future grid-interactive capabilities and advanced energy management programs.
How to Get Started
Commercial solar is a business decision that offers operational benefits and payback. The technical choices matter, but the financial model and integration strategy determine whether a project succeeds.
If you are considering a solar project now or in the future, it’s essential to contact a reliable and trusted solar company.
They’ll start with a site assessment to determine the feasibility of a solar system at your property by gathering actual utility data to assess the viability of a solar system on your property. This will provide you with a production profile, a realistic payback model, and financing options that align with your goals.
FSG Solar is Here to Help Your Business Take Control of Its Energy Costs
FSG Solar delivers end-to-end solar electrical construction, from engineering to installation and lifecycle maintenance. Backed by our 43+ years of utility and infrastructure integration expertise, we’re here to help your business take control of its energy costs.
Contact us to speak with one of our solar experts and to schedule a site assessment.
Frequently Asked Questions
How do I know if my facility is actually a good fit for commercial solar?
The fastest way is a site assessment that reviews your available space and structural capacity, shading, historical energy usage and peak demand, panel capacity, and utility interconnection rules. Those inputs are used to model production and ROI so you can see whether solar pencils out for your specific property.
What’s the biggest thing that slows down a commercial solar project timeline?
Permitting, utility approval, and interconnection are often the longest parts of the process and can take weeks or months depending on your jurisdiction and utility requirements. Starting these steps early—and submitting a complete application package—helps prevent delays from missing documents or design revisions.
If my building uses more power at night, does commercial solar still make sense?
It can, but it depends on how much of your solar production you can consume on-site during daylight hours and what your utility allows for export, storage, or curtailment. Pairing solar with load management (and potentially storage) can improve savings if your peak usage doesn’t line up with solar production.
What should I ask a commercial solar contractor to include in the system design and financial model?
Ask for annual kWh generation estimates, projected savings based on your usage patterns, available incentives, and a modeled payback and internal rate of return (IRR). You should also expect the plan to account for real-world variables like temperature effects, cleaning schedules, and shading impacts that can change output over time.
What maintenance costs or responsibilities do businesses usually underestimate with commercial solar?
Many teams underestimate ongoing monitoring, cleaning needs in dusty/industrial environments, inverter inspections and updates, and the value of documented electrical testing for safety and warranty support. A defined O&M plan with response times and repair responsibilities helps protect performance and projected payback.
